Track Record

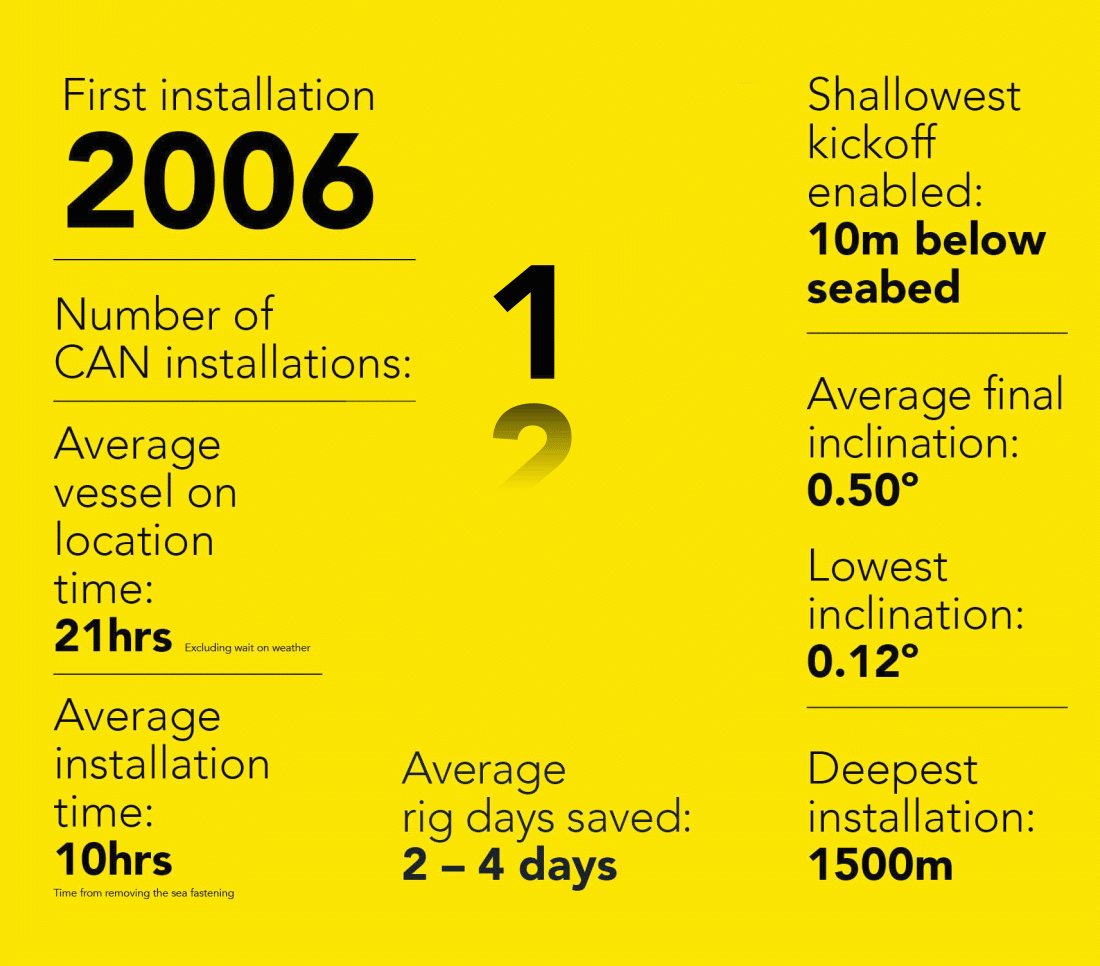

Each installation saves an average of 2-4 rig days and 500 tons CO2 emissions.

Explore Neodrill's track record by interacting with the map below. Use the search filters, click on points, or countries for more information. Detailed search results are available below the map.

Number of CAN-installations:

N/A

Search

Reset
2006
2007
2008
2009
2010
2011
2012
2013
2014
2015
2016
2017
2018
2019
2020
2021
2022
2023
2024
2025

2006

2025

0
100
200
300
400
500
600
700
800
900
1000
1100
1200
1300
1400
1500

0

1500

5
6
7
8
9
10
11
12
13
14
15
16
17
18
19
20

5

20

Search Results


Dvalin Nord

Harbour Energy

6507/7

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Norwegian Sea

406m

8.50 m

0.30°

8.5 hrs

CAN-parking

Xmas tree / OWWS parking


Zagato North

Vår Energi

7122/8-4 S

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Barents sea

405.6 m

13.0 m

0.16°

6.05 h

CAN-ductor

Exploration


Pelican South

OMV Petrom

VXT581003 PS 1-3

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Black Sea

124 m

10.00 m

0.40º

13 hrs

CAN-integrator

Production


Dvalin Nord

Harbour Energy

6507/7

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Norwegian Sea

406m

8.50

0.29°

6 hrs

CAN.parking

Xmas tree / OWWS parking


Pelican South

OMV Petrom

VXT581002 PS 1-1

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Black Sea

124 m

10.00 m

0.28º

18hrs

CAN-integrator

Production


Pelican South

OMV Petrom

VXT581001 PS 1-4

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Black Sea

124 m

10.00 m

0.53º

19 hrs

CAN-integrator

Production


Blåmann

Vår Energi

7121/9-2

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Barents Sea

338 m

12.7 m

0.18°

8.25 h

CAN-ductor

Exploration


Pelican South

OMV Petrom

VXT581004 PS 1-2

Year

Region

Water depth

Length

Final inclination

Installation time

2025

Black Sea

124 m

10.00 m

0.23º

16 hrs

CAN-integrator

Production


Nova W-3

Harbour Energy

35/9

Year

Region

Water depth

Length

Final inclination

Installation time

2024

Norwegian Sea

369 m

11.00 m

0.23º

20 hrs

CAN-parking

Xmas tree parking

Neodrill circle.png

NEXT STEPS

Learn about other

CAN technologies

Group 85.png

Learn about CAN-enabled solutions

Group 20.png

Speak with an expert

Group 19.png
bottom of page
